Skip to content
Vinod Jose

8 min· water

The old system hid the bill

Two official reports show what an old billing system was costing two large utilities, once they tried to replace it.

In July 2023, an independent investigation of Project Cornerstone, the billing replacement at WSSC Water in Maryland, went to the utility's commission. The report says the first contract for the new billing system was approved for $15 million. It puts the final cost at about $121 million.

I believe an old billing system is a loan that a utility keeps paying interest on, and the interest stays out of sight until the day the system has to change. WSSC and the Los Angeles Department of Water and Power are two cases where a public report wrote that bill down.

1. What technical debt means

Ward Cunningham, a software developer, gave us the idea in a 1992 conference paper: "Shipping first time code is like going into debt. A little debt speeds development so long as it is paid back promptly with a rewrite." He added: "Every minute spent on not-quite-right code counts as interest on that debt."

In a utility, the same thing happens with a system that stays in service for decades. Each year it saves the cost of a replacement. Each year it also gets harder and more expensive to change.

2. WSSC: a 1990 mainframe and a new rate structure

The investigators describe the old system plainly. It was an IBM mainframe "built in the late-1980s and put into service in 1990." The rate software used COBOL, and "fewer and fewer programmers were proficient in programming and patching the rate structure software."

WSSC replaced it because the system was "severely outdated" and "could not accommodate a new rate structure for customers." That is the interest coming due. The system ran for almost 30 years, and when the rates had to change, it could not follow.

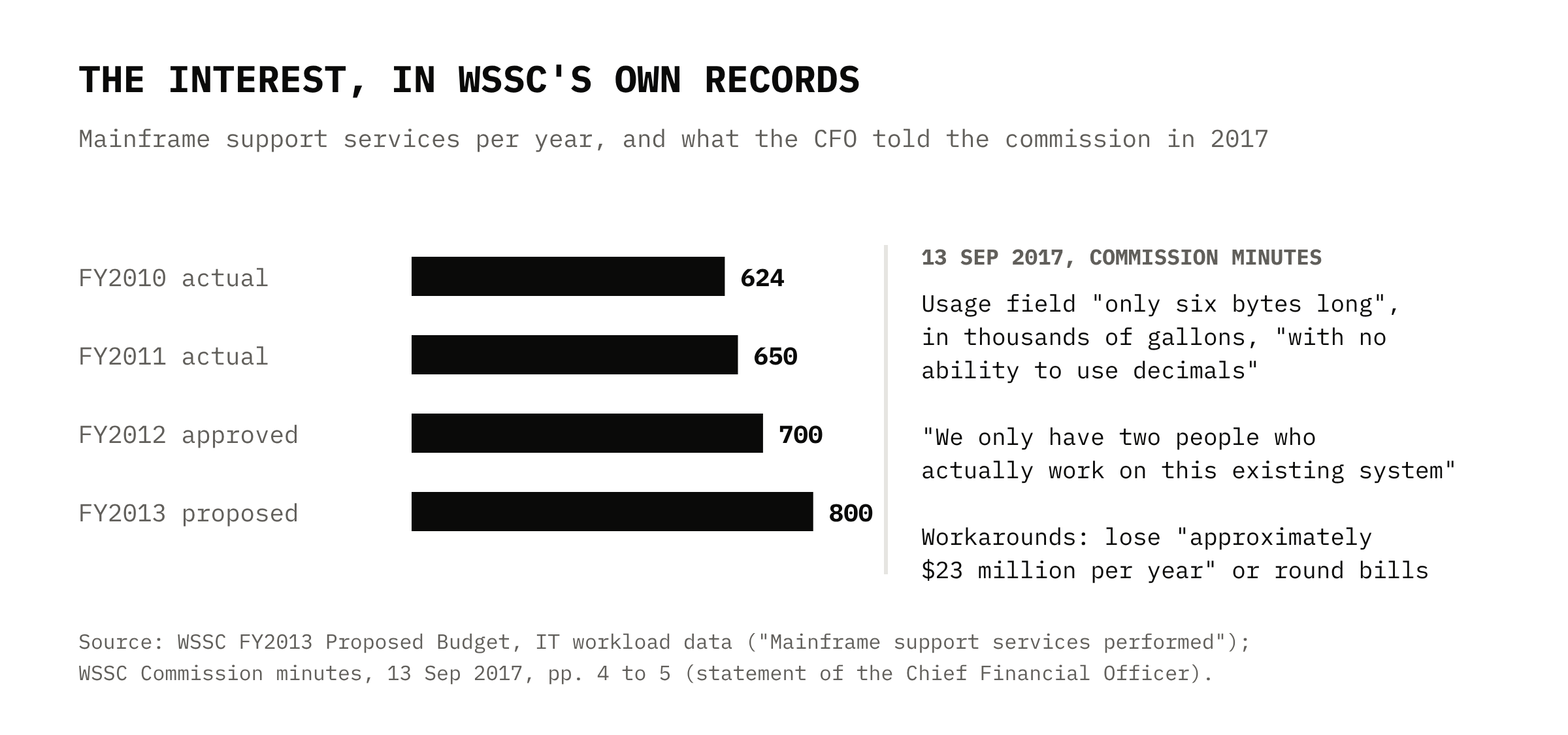

WSSC's own records show the interest years before the report. Its FY2013 proposed budget counted 624 "mainframe support services" in FY2010 and planned for 800 in FY2013. In September 2017, chief financial officer Joseph Beach told the commission why the old system could not bill the tiered rates it was studying. The field that held each customer's usage was "only six bytes long," measured in thousands of gallons, "with no ability to use decimals." The workarounds meant losing "approximately $23 million per year" or rounding customer bills. "We only have two people who actually work on this existing system," he said, and then: "So why didn't we know about these existing billing system limitations before testing? Quite honestly, we should have." Management recommended moving the new rate structure to FY20.

FY2010, actual624
FY2011, actual650
FY2012, approved700
FY2013, proposed800
Mainframe support services WSSC performed each year, as its own budget counted them: up by about a quarter in three years (derived), with the replacement still years away.WSSC Water, FY2013 Proposed Budget, IT workload data ("Mainframe support services performed"); WSSC Commission minutes, 13 Sep 2017, pp. 4 to 5 (statement of the Chief Financial Officer).

The new billing system went live on July 2, 2019. After go-live, WSSC spent about $51.4 million more "on stabilization, knowledge transfer, software licensing, staff augmentation, and managed services." The report also says the project "ultimately succeeded in implementing a working billing system." Both statements are in the same document, and I think both are fair.

The plan and the outcome are both on the record. WSSC's FY2020 budget scheduled the new billing system for May 2019 and a second release, for work and asset management, in FY2020. The report says about $15.8 million was spent on that second release before it was dropped. The FY2027 proposed budget, published in 2026, still funds "modernization of some of our legacy systems, including work and asset management," and its IT section still supports databases "including mainframe."

3. LADWP: a 40-year-old system, highly customized

The California State Auditor reviewed the LADWP billing project in March 2015 (report 2014-105). The new customer information system replaced "a 40-year-old, highly customized system that was technologically outdated." The department "originally budgeted $87 million" and "more than doubled that budget to nearly $181 million over time." The report's title warns that total costs may go beyond $200 million.

The system launched in early September 2013 for roughly 3.8 million customers. Customers then complained "of late utility bills, unwarranted shut-off notices, and excessive wait times." In the three months after launch, call waits averaged about 24 minutes against a goal of three. The auditor found that the department "minimized or ignored the severity of the issues" when it decided to launch.

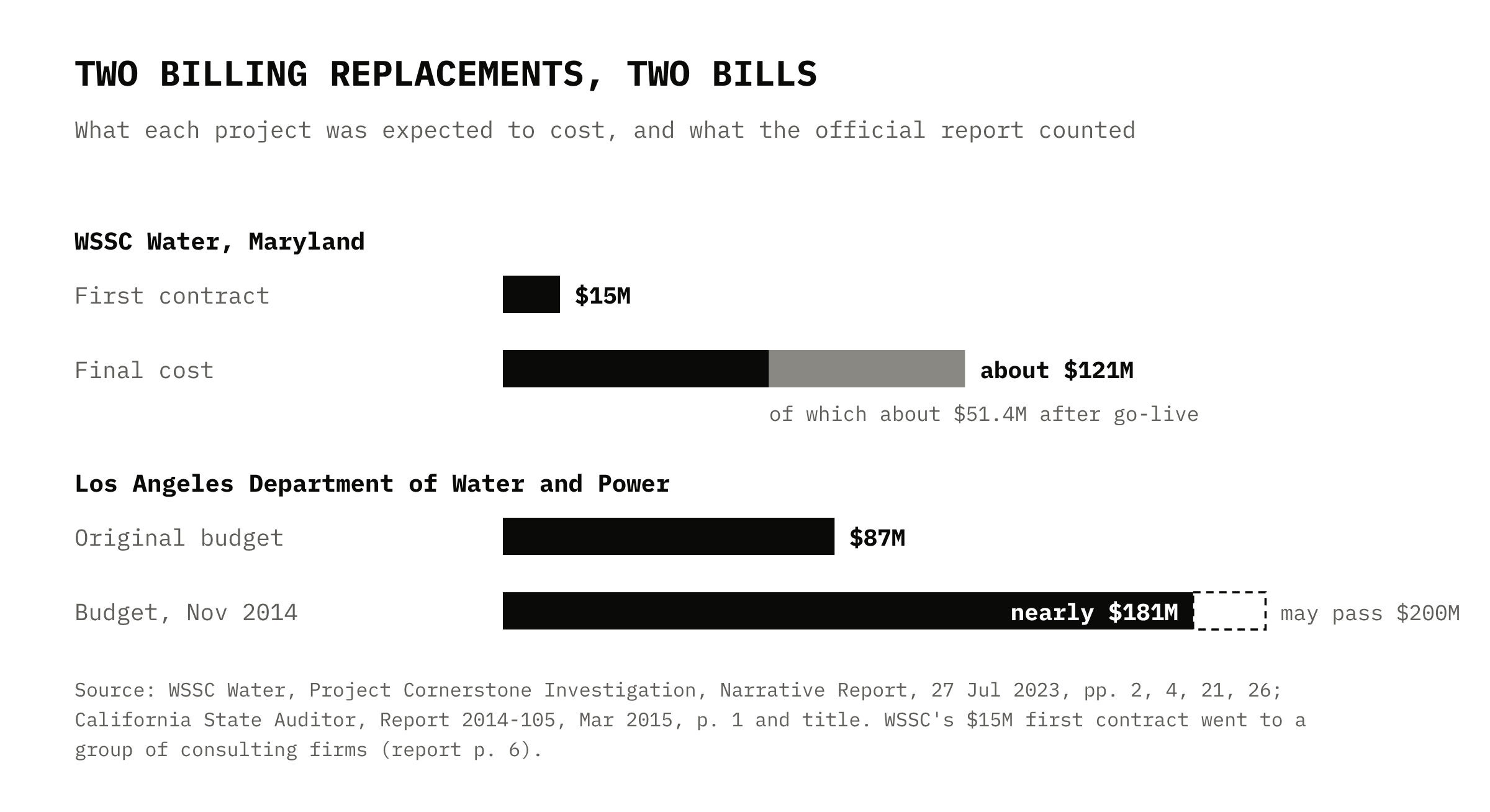

WSSC: first contract$15M
WSSC: final costabout $121M
LADWP: original budget$87M
LADWP: budget by Nov 2014nearly $181M
What each replacement was expected to cost, and what the official report counted. About $51.4 million of WSSC's final cost came after go-live. The State Auditor's title warned that LADWP's total could pass $200 million.WSSC Water, Project Cornerstone Investigation, Narrative Report, 27 Jul 2023, pp. 2, 4, 21, 26; California State Auditor, Report 2014-105, Mar 2015, p. 1 and title.

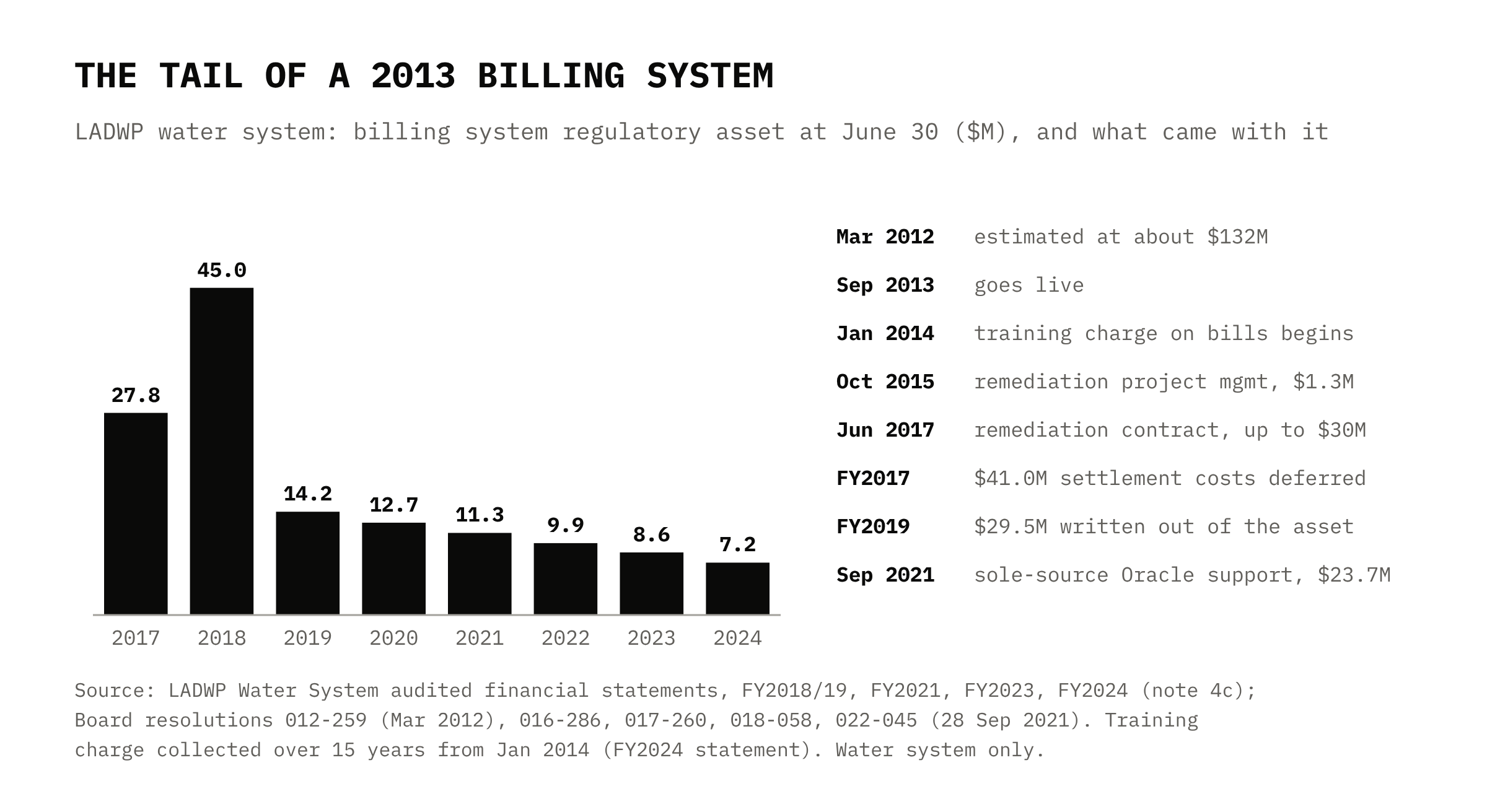

LADWP's own board records show how long the tail runs. In March 2012, a board resolution said the new system was "estimated to cost approximately $132 million." After launch, the board hired outside project managers for "remediation of the defectively implemented CC&B Billing System" under a class action settlement: $1.3 million in October 2015, then up to $30 million in June 2017. For the year ending June 30, 2017, it recorded $41.0 million of class action settlement costs as a regulatory asset. In September 2021, it approved a sole-source support agreement with Oracle for up to $23.7 million. Since January 2014, customer bills have also carried a charge for training staff on the system, now spread over 15 years. On June 30, 2024, the water system still had $7.2 million of it to collect.

Part of that tail ended in federal court. In February 2015, answering the State Auditor, LADWP's board said an investigation had "preliminarily found that a vendor hired to assist in implementing CIS intentionally misled the department." The auditor reported this as the board's assertion, and noted that neither the department nor the board had told it about an investigation or possible litigation until then. In March 2015 the city sued PricewaterhouseCoopers, alleging, in the California Supreme Court's words, that it "had fraudulently misrepresented its qualifications." That claim was never tried. Federal prosecutors later described a "collusive lawsuit" brought by a ratepayer and settled for $67 million, which the city's outside lawyers used to settle the billing claims on the city's terms. The $1.3 million project management contract above went to the law firm of the city's special counsel against PwC. The $30 million contract went to Aventador, a company he set up. In November 2023 the special counsel was sentenced to 33 months in federal prison over a kickback of nearly $2.2 million, and he admitted bribing LADWP officials to win the Aventador contract. LADWP's general manager at the time was sentenced to six years. The city dismissed its suit against PwC in September 2019, and a trial court ordered the city to pay $2.5 million in discovery sanctions.

June 30, 2017$27.8M
June 30, 2018$45.0M
June 30, 2019$14.2M
June 30, 2020$12.7M
June 30, 2021$11.3M
June 30, 2022$9.9M
June 30, 2023$8.6M
June 30, 2024$7.2M
The billing system's regulatory asset on the LADWP water system's books at June 30 of each year, still being collected from customers a decade after launch. Around it in the board's records: a $132 million estimate in 2012, remediation contracts of $1.3 million in 2015 and up to $30 million in 2017, and a $23.7 million sole-source Oracle support agreement in 2021.LADWP Water System audited financial statements, FY2018/19, FY2021, FY2023 and FY2024, note 4(c); Board resolutions 012-259, 016-286, 017-260 and 022-045. Water system only.

4. Where the interest came from

Read the two reports side by side and the same two words show up: customization and people. LADWP's old system was "highly customized." At WSSC, fewer people each year could patch the code. Then the people who ran the replacement left too. Of the 20 WSSC staff who held key roles on Cornerstone, "only four remain currently employed," and the report links that turnover to "loss of institutional and project specific knowledge."

None of this blames the people who built those systems. A custom system was a reasonable choice in the 1970s and in 1990. The cost of that choice grows a little every year, and nobody sends a monthly statement.

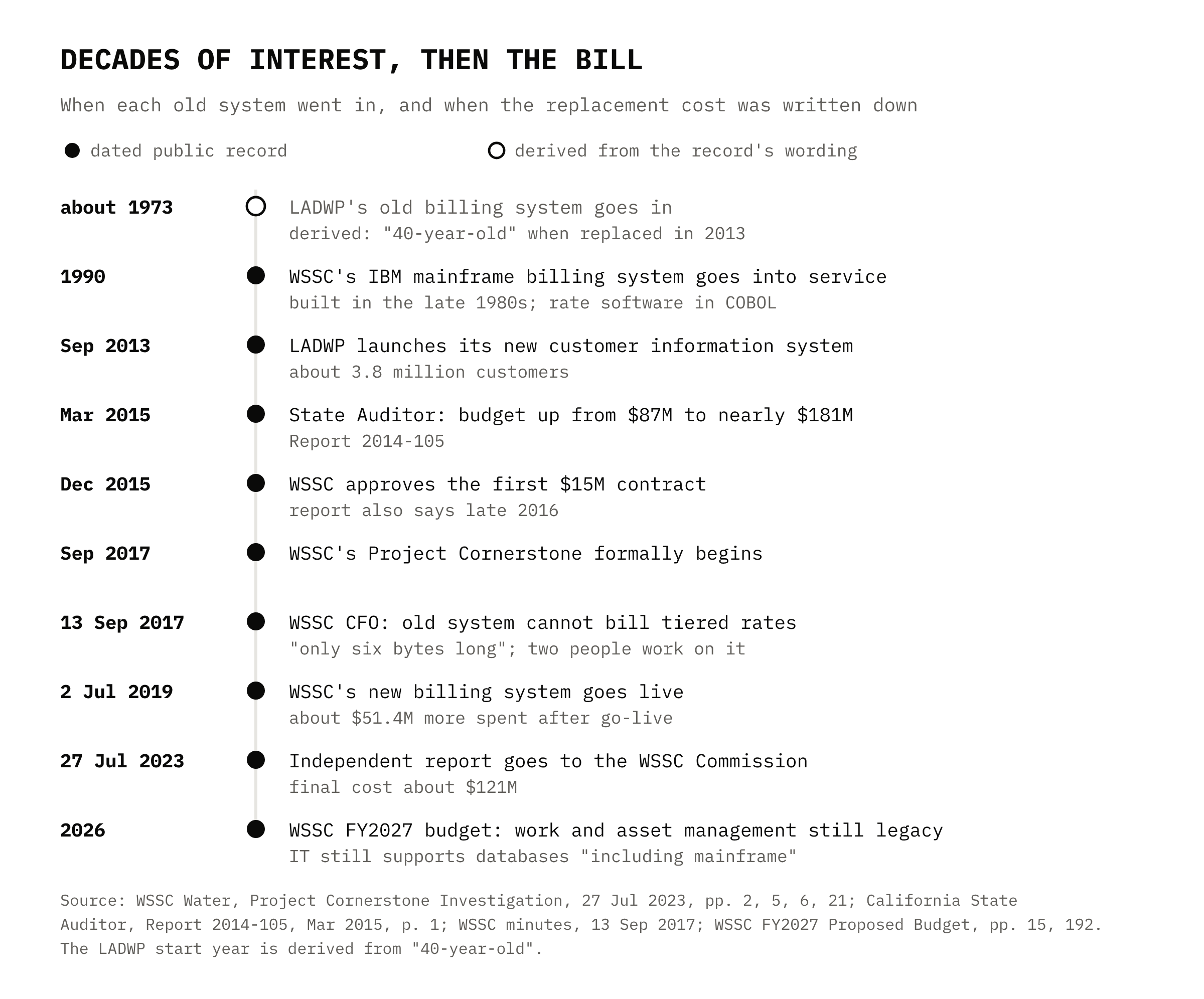

WhenWhat the record shows
about 1973LADWP's old billing system goes in (derived from "40-year-old" in 2013)
1990WSSC's mainframe billing system goes into service; rate software in COBOL
Sep 2013LADWP launches its new customer information system, about 3.8 million customers
Mar 2015State Auditor: budget up from $87M to nearly $181M
13 Sep 2017WSSC's CFO: the old system cannot bill the new rate structure
2 Jul 2019WSSC's new billing system goes live; about $51.4M more is spent after go-live
27 Jul 2023Independent report to the WSSC Commission: final cost about $121M
2026WSSC's FY2027 budget still lists work and asset management among its legacy systems
Decades of interest, then the bill. Both old systems ran for close to thirty years or more before a public report wrote down what replacing them cost.WSSC Water, Project Cornerstone Investigation, 27 Jul 2023, pp. 2, 5, 6, 21; California State Auditor, Report 2014-105, Mar 2015, p. 1; WSSC minutes, 13 Sep 2017; WSSC FY2027 Proposed Budget, pp. 15, 192. The LADWP start year is derived from "40-year-old".

5. What it means for utilities

The question I would ask first is this: what does your oldest system cost you every month? Count the staff hours of workarounds, the changes you postponed, and the rate options you never studied because the software could not bill them.

Utility ITOldest system / Customer billingmonthly review
Customer billing, in service since 1991
Lake Aldon Water District · reviewed monthly
Interest paid this month
Cost of keeping itMonthNote
Staff hours on workarounds64 hmanual bill fixes, exports
Changes postponed3rate pilot, e-bill, autopay
Rate options it cannot bill2Blocks rate study
Contractor patch time18 hCOBOL contractor
Who can change it
RoleStatus
Staff programmerRetires 2028
ContractorOn call
Hardware supportEnded
Compare with
The last big IT project: planned cost against actual
What a monthly look at the interest could contain: the hours spent working around the system, the changes it holds back, and how few people can still change it. A utility's own screen, drawn for this essay; AquaIntel does not make it. Mockup on invented data: not a customer, not a real utility.

Three questions help put a number on it:

  1. Which systems hold your billing, asset and GIS data, and how old is each one?
  2. Who knows how the oldest system works, and what happens when they retire?
  3. What did your last big IT project cost compared to plan?

6. What it means for vendors

Do not take over scope you cannot deliver. The WSSC report found that the utility "permitted Oracle to dominate key elements" of the project, and that Oracle "made a late change to the scope of work to effectively remove Oracle's responsibility to provide well-defined deliverables." The report also says WSSC "did not have the personnel qualified to act as the SI" (systems integrator). In an internal review that the report quotes, a WSSC staff member said: "[w]e became the SI."

In my view, a vendor that wins a project with a loose scope wins a dispute later. Write down who integrates, who cleans the data and who supports the system after go-live, before the contract is signed.

7. What to watch next

  1. Rate structure changes. WSSC's trigger was a rate structure the old system could not bill. Watch rate studies and public service commission rulings.
  2. Contract amendments on billing projects. Change orders and "post-go-live support" items appear in board agendas and minutes long before an audit does.
  3. Audit and inspector general reports. State auditors, city auditors and utility inspectors general publish these. They are where the full bill gets written down.

The budget lines, minutes and audited statements above come from the public records we collect at AquaIntel. Read year by year, they show the interest long before an audit adds it up.

The bill for an old system arrives a little every month. The replacement project is where somebody finally adds it up.

I write about US water utility buying signals every two weeks. .
